| Health Posts – Dolakha |
|
| 2 Jul 15 |
Approved by ANMF Projects Committee. |
| 8 Jul 15 |
Proposal received by ANMF/America. |
| 11 Jul 15 |
Approved by ANMF/Nepal Board. |
| 12 Jul 15 |
Approved by ANMF/America Board. |
| 17 Aug 15 |
$100,000 sent to ANMF/Nepal. |
| 1 Sep 15 |

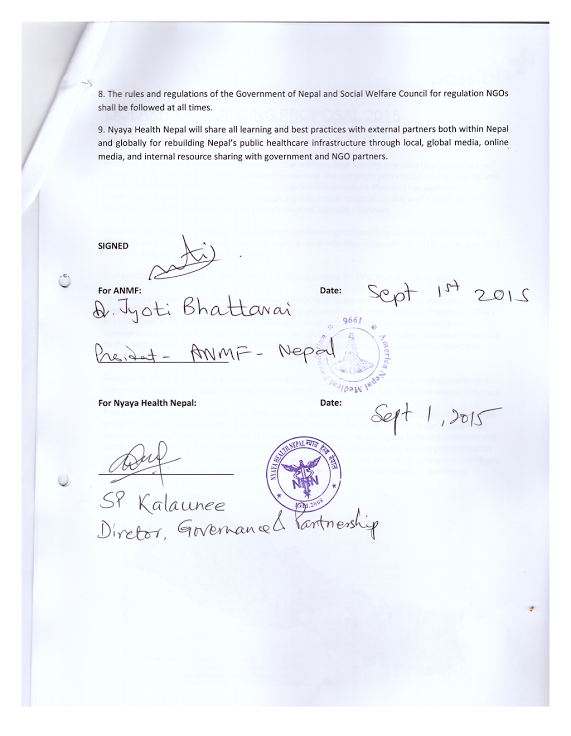

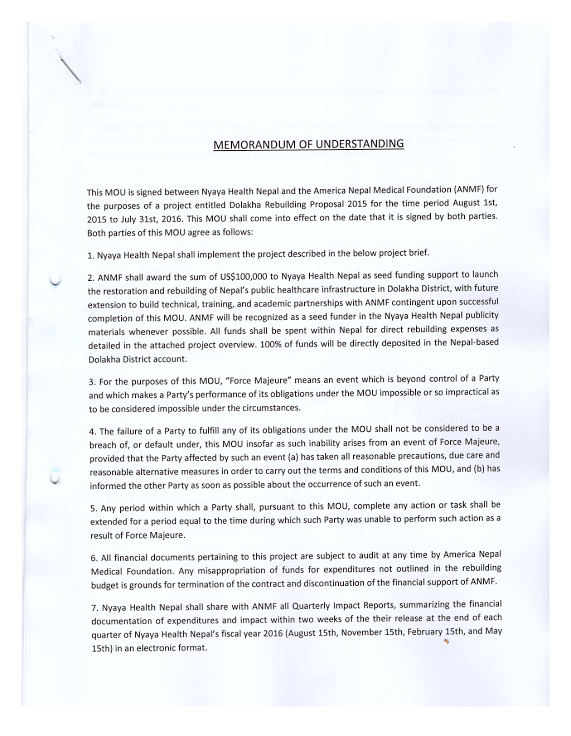

Memorandum of understanding signed. |
| 1 Sep 15 |
Funds transferred to Possible. |
| 16 Oct 15 |

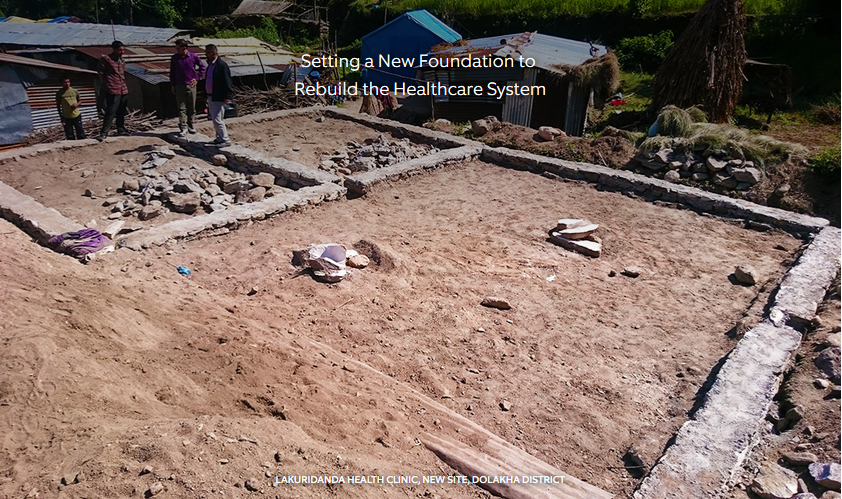

ANMF supported $100,000 to Nyaya Health Dolakha (Possible) for rebuilding the destroyed health care centers at Dolakha district. Following the devastating earthquake, Nyaya Health Nepal signed MOU with the Ministry of Health and Population (MOHP) for rebuilding health care in Dolakha district. Based on the needs assessed by the MOHP, Nyaya Health Nepal has committed to build 21 prefabricated health facilities (Type 2) in the District as designed and guided by MOHP. In coordination with the DHO, six sites have been selected for the first batch of reconstruction effort in Dolakha. These sites were selected based serving population. However road accessibility to the sites has also been a biggest determining factor here. Groundwork has started in Lakuridanda HP. The selected six HPs are:
- Lakuridanda HP
- Boch HP
- Bhushafeda HP
- Katakuti HP
- Ghyangsukathokar HP
- Lapilang HP

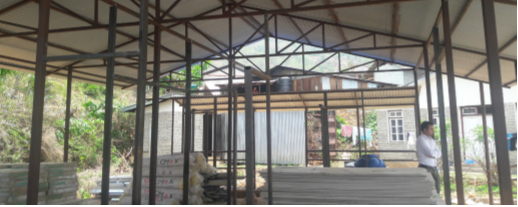

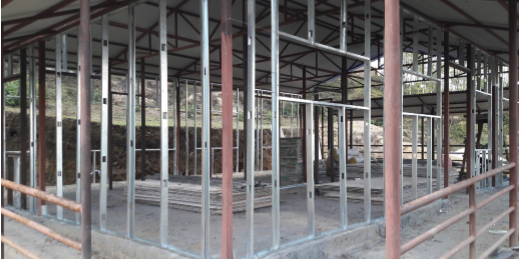

The level has been cleared and foundation wall has been built. The progress has recently halted as the supply of required materials to the site has been compromised owing to acute fuel shortage in the last week of September. |
| 29 Jan 16 |
Report received. Reconstruction team has gone to 17/21 sites so far. Out of them, work is going smoothly in 10/21 sites. Work has not yet started in 2/21 sites (Marbu, Namdu) as the sub-contractors are yet to be identified. In 1/21 site (Bhirkot), there is a functional health post building and the next step is still not clear. In 4/21 sites, there still have been land issues. |
| 20 Mar 16 |

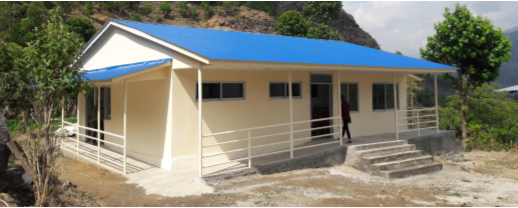

Report received. Nyaya Health Nepal’s rebuilding team has reached to 20/21 sites. Boch HP has been completed and is scheduled to be inaugurated on March 3. Rebuilding work is going on in 10/21 sites. |
| 7 Jun 16 |

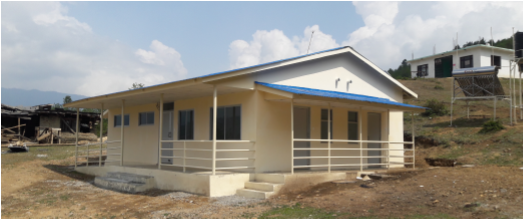

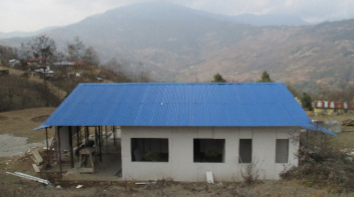

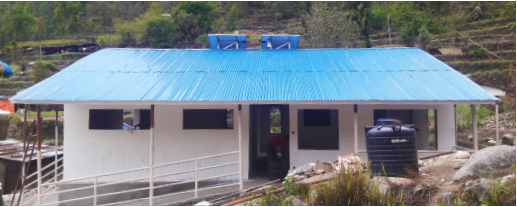

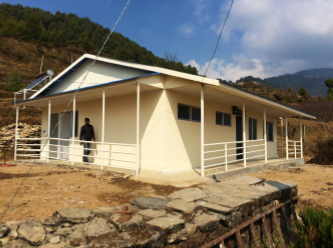

Report received. Boch, Mali and Lakuridanda health posts have been completed. Rebuilding work is going on in 9/21 sites. |
| 25 Jun 16 |
Report received. Rebuilding work has been completed in 6 of 21 sites: Boch, Mali, Lakuridanda, Sahare, Hawa, and Bhusafeda. Rebuilding work is going on in another 9 sites including work started in three new sites in May after clearance on land issue: Orang, Marbu and Lamidanda HP. Consultation with DHO is going on to address the land issues in the remaining 6 sites. |
| 27 Jan 17 |
Report received from ANMF/Nepal. Rebuilding work has been completed in 10 of 21 sites and work is ongoing in 5. Appropriate land has not yet been made available for the rebuilding work in the remaining 6. |
| 2 Apr 17 |
Report received from ANMF/Nepal. |
| 13 May 17 |
Project successfully completed and closed by ANMF. |
